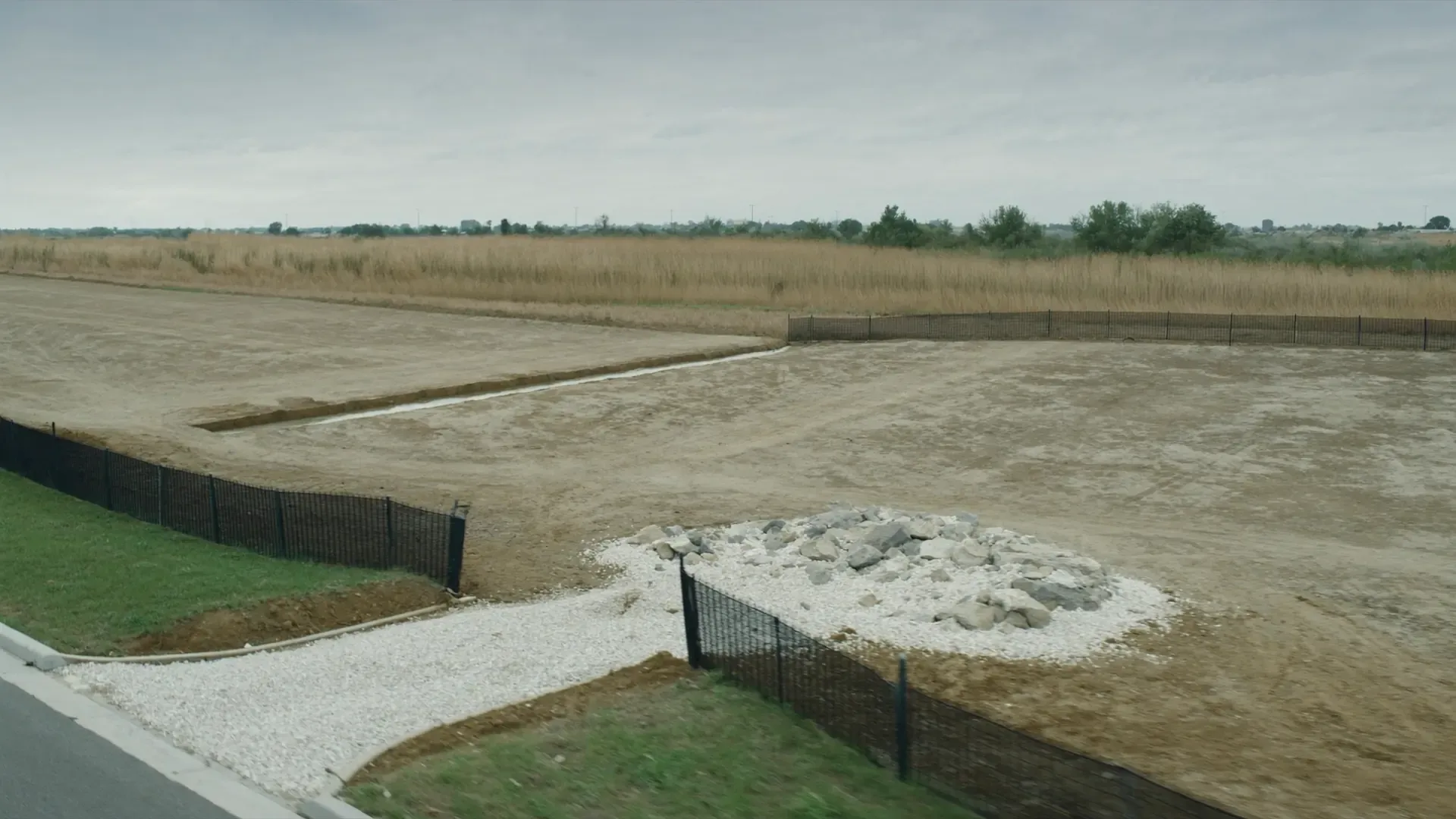

Grading the pad for an Austin-area metal building: permits and stormwater acreage

Site prep for a metal building around Austin runs in a fixed order: the site plan and the county or city permit first, then clearing, then a pad graded so water leaves the slab on every side.

What sets the paperwork is how much ground the work disturbs, which of the six counties the lot is in, and whether it sits inside a city. Disturb one acre and TCEQ's construction stormwater permit applies; at five acres a Notice of Intent and a fee go in as well.

Show the full introduction

In Travis County a commercial pad also meets the county's own checklist, and inside Austin the trees are regulated before one comes down.

Inside Georgetown

Commercial building permit, 30 business day review

Georgetown requires a Commercial Building Permit application through My Government Online for new ground-up commercial construction, remodels, tenant finish-outs, additions and facade changes, with bookmarked PDF plans, the TDLR registration, a ComCheck and proof of transportation impact fees, and it will not accept the application until Planning has issued first-round site plan comments.

From City of Georgetown Building Inspections, 300-1 Industrial Ave. (read September 20, 2026).

Williamson County, outside city limits

No county building permit, building code or certificate of occupancy

Williamson County's own pages answer the building permit question by pointing to the County Engineer's Road and Bridge Division, which issues a Certificate of Compliance that verifies whether the property is in a floodplain, and say nothing else is needed from that office unless a driveway is being built.

The source was read and does not list this. From Williamson County, frequently asked questions, infrastructure and developers (read September 20, 2026).

Williamson County: the city desk and the county desk, each read at its own page. The whole record is on that county's sheet.

What does grading a metal building pad around Austin involve, step by step?

Four steps, in order: a site plan showing where the building, the drive and the drainage go; the permit or certificate the county or city issues on it; clearing inside the limits of construction; and the pad, cut and filled to a level bench, compacted, and shaped so runoff moves away from the future slab instead of under it.

Whoever moves the dirt clears and grades it, and on this site that is one independent metal building contractor. Where the county record calls for a sealed site plan, a Texas professional engineer seals it: Travis County's non-residential development permit takes a site plan sealed by a Texas-licensed engineer, Bastrop County's non-single-family permit a civil plan set stamped by one, and Caldwell County's commercial site construction permit engineer-certified drawings before land clearing.

The ground sets the price of the cut. West of the Balcones Escarpment, the 1974 Travis County soil survey names breaking and moving massive limestone for site leveling as the main urban limitation on the Tarrant soils, about eight inches deep over rock. East of it the Houston Black clays crack when dry and, in the survey's words, shrink and swell enough to damage foundations, so the pad's drainage matters as much as its level.

FromUSDA Soil Conservation Service, Soil Survey of Travis County, Texas (1974), climate and parent material sections (read September 20, 2026). FromUSDA Soil Conservation Service, Soil Survey of Travis County, Texas (1974), general soil map and engineering uses of the soils (read September 20, 2026). FromUSDA Soil Conservation Service, Soil Survey of Travis County, Texas (1974), general soil map, Brackett and Tarrant series, parent material (read September 20, 2026). FromTravis County TNR Development Services, Commercial Site Plan (read September 20, 2026). FromBastrop County Development Services, and the Development Services application fees (read September 20, 2026). FromCaldwell County Development Ordinance, revised February 14, 2023, and the subdivision and development fee schedule (read September 20, 2026).

Grading is construction in the county records, so the permit comes before the clearing

None of the six county records treats the pad as a step before the paperwork.

  • Travis County: a development permit before any construction or development outside the cities, under Travis County Code Chapter 464, on scaled plans showing topography and the floodplain.

  • Williamson County: the county's own pages list no county building permit outside its cities. They do require a $25 Certificate of Compliance for all structures or other developments outside a floodplain, and construction is authorized only after county approval.

  • Bastrop County: a development permit for any external development, applied for before building or placing a structure; a non-single-family application carries a drainage report meeting the county's zero net increase in runoff policy.

  • Caldwell County: a construction permit with engineer-certified drawings before land clearing or construction, and commercial site construction means all construction, grading or added impervious cover not otherwise exempt.

  • Lee County: a Development Permit for any structure larger than 100 square feet, and no work in a special flood hazard area until the Floodplain Development Permit issues.

  • Burnet County: first a 911 address, then the building permit. Class A, $25, no inspection, for a site clear of every flood hazard area; Class B, $400, for a site within one, with an elevation certificate and a flood-zone site plan.

  • Inside Austin the file is the site plan, required for any site work on a non-residential site unless the project qualifies for an exemption, and the exemption for construction up to 1,000 square feet holds only when no tree over eight inches is removed and the work is outside the 100-year floodplain. In its extraterritorial jurisdiction Austin issues no new construction permit and sends the applicant to the county.

FromCity of Austin Development Services, site plans, exemptions and corrections, and Land Development Code 25-5-2 on Municode (Supp. No. 174) (read September 20, 2026). FromCity of Austin Development Services, relocation permit, and City of Austin Planning, jurisdictional matters (read September 20, 2026). FromTravis County TNR, floodplain maps, and Travis County Code Chapter 464 (read September 20, 2026). The source was read and does not list this. FromWilliamson County, frequently asked questions, infrastructure and developers (read September 20, 2026). FromWilliamson County, floodplain management, and the Certificate of Compliance form (read September 20, 2026). FromBastrop County Development Services, and the Development Services application fees (read September 20, 2026). FromBastrop County Development Services, floodplain management (read September 20, 2026). FromCaldwell County Development Ordinance, revised February 14, 2023, and the subdivision and development fee schedule (read September 20, 2026). FromLee County Development Services Department, and its Instructions for Application for Proposed Development, which carry the 100 square foot line and the fee schedule (read September 22, 2026). FromLee County, floodplain development provisions and the Flood Damage Prevention Ordinance (read September 20, 2026). FromBurnet County, on-site sewage facilities and development permits (read September 20, 2026).

Which TCEQ stormwater tier does the pad fall in?

The acreage the work disturbs, not the size of the building, sets the tier. General permit TXR150000 calls five or more disturbed acres a large construction activity and one acre to under five a small one; below one acre, with no larger common plan behind the work, the permit does not reach. The common plan is the catch: the total disturbed under one plan counts, so the pad, the drive and the parking apron add up, and TCEQ's own example of a project that grows from 0.93 to 1.08 acres moves into the one-to-five-acre tier.

On the large tier, an electronic Notice of Intent gets provisional coverage at once, and a paper one seven days after its postmark. The permit runs from March 5, 2023 to its expiration on March 5, 2028. A commercial-use metal building plus its drive and parking can pass the acre line on site work alone; an RV or equipment storage building on a ranch tract may stay under it. Every step in order: the Austin-area metal building route.

TCEQ construction stormwater by acres disturbed, general permit TXR150000, read 2026-09-20.

On a phone this table scrolls sideways.

Acres disturbedTierFiles and postsFee
Below one, with no larger common planOutside the permitNothing; a larger plan's total still countsNone stated
One to under fiveSmall construction activityPollution prevention plan ahead of construction; site notice TCEQ-20963 up two days before starting and kept up until final stabilization; no Notice of IntentNone required
Five or more, including a common plan that will reach fiveLarge construction activityPollution prevention plan; Notice of Intent through STEERS; large site notice up until final stabilization; Notice of Termination due within 30 days of final stabilization$225 electronic, $325 paper; no annual fee

FromTexas Commission on Environmental Quality, stormwater general permit for construction activities (TXR150000) (read September 20, 2026). FromTexas Commission on Environmental Quality, stormwater discharges from construction activities, less than one acre (read September 20, 2026). FromTexas Commission on Environmental Quality, stormwater discharges from small construction activities, site notice steps (read September 20, 2026). FromTexas Commission on Environmental Quality, stormwater discharges from large construction activities, steps (read September 20, 2026). FromTexas Commission on Environmental Quality, TPDES general permit TXR150000, 2023 construction general permit, Part IX (read September 20, 2026).

In the Edwards Aquifer contributing zone the plan is approved before the pad is cut

Travis and Williamson are on TCEQ's eight-county list for the Edwards Aquifer Protection Program, and the stormwater permit builds in the hold: under Part II.C.5, a site regulated under 30 TAC Chapter 213 starts no construction until its Edwards Aquifer protection plan is approved.

TCEQ's decision page settles whether a pad needs a Contributing Zone Plan with two tests: a regulated activity under 30 TAC 213.22(6), and a disturbance reaching five acres or forming one piece of a larger development or sale plan. Unless both answers are yes, the page says no plan is needed. When one is, it is approved before construction begins and includes construction stormwater controls, which the TPDES pollution prevention plan can satisfy. Which zone a parcel sits on is whatever TCEQ's official maps show; the viewer is informational, no page read describes a written parcel determination, and the Austin Regional Office is (512) 339-2929. The clock and the fees: contributing zone plans, Travis and Williamson.

FromTexas Commission on Environmental Quality, Edwards Aquifer Protection Program (read September 20, 2026). FromTexas Commission on Environmental Quality, TPDES general permit TXR150000, 2023 construction general permit, Part II.C.5 (read September 20, 2026). FromTexas Commission on Environmental Quality, Edwards Aquifer Protection Program, what plans you might need, and the Contributing Zone Plan page (read September 20, 2026). The agency pages were read and describe no written parcel determination. FromTexas Commission on Environmental Quality, Edwards Aquifer map viewer (read September 20, 2026).

What does Travis County's checklist trigger on a commercial pad?

Six triggers, from the county's Non-Residential Development Checklist, revised May 11, 2023: a stormwater pollution prevention plan at one acre or more of disturbance; possible permanent water quality controls above 10,000 square feet of new impervious cover; an environmental resource inventory above 10,000 square feet of disturbance; a 45 percent impervious cover limit unless the driveway is on a state road; a city signature or permit before a county permit issues in any city's extraterritorial jurisdiction; and a traffic impact analysis determination worksheet for a new county driveway.

Read those against a pad. Ten thousand square feet of impervious cover is a 100 by 100 foot footprint, so a shop with a drive and an apron reaches the water quality and inventory lines well before the acre line for stormwater. The checklist is a county document for county permits, and the county's floodplain jurisdiction runs only outside city limits, so a lot inside a city answers to that city instead.

FromTravis County TNR, non-residential development checklist (read September 20, 2026). FromTravis County TNR, floodplain maps, and Travis County Code Chapter 464 (read September 20, 2026).

Which trees can come out inside Austin, and does the rule reach the ETJ?

Inside Austin's full purpose and limited purpose jurisdictions, a tree 19 inches or more in diameter, measured 4.5 feet above the ground and of any species, is protected, and a tree permit is required to remove or impact one. A heritage tree is 24 inches or more and one of ten listed species, including all oaks, pecan, cedar elm and bald cypress; its removal is prohibited except as the code provides, and a variance for a tree 30 inches and larger goes through a public process. Every tree eight inches and larger is surveyed on a commercial site plan submittal, and the FY 2025-26 arborist site plan review runs from $1,180.71 for up to five trees to $3,815.92 for up to 200.

The ordinance does not apply in the extraterritorial jurisdiction, which the city describes as unincorporated land within five miles of its boundary and not inside another city. Austin issues no new construction permit there and sends the applicant to the county, and Travis County's checklist wants the city's signature or permit before the county permit issues in any city's ETJ.

FromCity of Austin Development Services, city arborist, and the tree review and inspection fees (FY 2025-26) (read September 20, 2026). FromCity of Austin Development Services, relocation permit, and City of Austin Planning, jurisdictional matters (read September 20, 2026). FromCity of Austin Development Services, site plans, exemptions and corrections, and Land Development Code 25-5-2 on Municode (Supp. No. 174) (read September 20, 2026). FromTravis County TNR, non-residential development checklist (read September 20, 2026).

Questions on permits and pricing, from the record

Does pad grading and site prep need a permit in Williamson County outside the cities?

Williamson County's own pages list no county building permit, building code or certificate of occupancy outside its cities. What it does want before construction is a Certificate of Compliance, the $25 floodplain check for any structure or other development outside a floodplain, or a Floodplain Development Permit where a regulated floodplain is within or adjacent to the work. A commercial building also needs the Fire Marshal's fire code permit.

How many acres of disturbance put a metal building pad under TCEQ stormwater coverage?

One. General permit TXR150000 treats one acre to under five as a small construction activity: pollution prevention plan, site notice on a post, no Notice of Intent, no fee. From five acres it is a large construction activity, filing a Notice of Intent at $225 electronic or $325 on paper. Below one acre the permit does not apply, unless a larger common plan takes in the work.

Can a heritage oak be removed for a metal building pad inside Austin?

Not as a matter of course. Inside Austin's full and limited purpose jurisdictions, a tree 24 inches or more in diameter and one of ten listed species, all oaks included, is a heritage tree; its removal is prohibited except as the code provides, and a variance for a tree 30 inches and larger goes through a public process. The ordinance does not apply in the extraterritorial jurisdiction.

Who grades the pad, and who seals the site plan it is built from?

The grading crew on the job does the clearing and the cut. A Texas professional engineer seals the site plan where the county record says so: Travis County's non-residential development permit takes a site plan sealed by a Texas-licensed engineer, and Caldwell County's commercial site construction permit takes engineer-certified drawings before land clearing. No published price exists for the cut; it depends on this lot.

Pricing request, six fields, no charge

Price a metal building, county first

Fill it in this order: county first, since it names the permit desk; then the building; then the start window, which sets what gets looked at first.

By submitting this form, I agree that Central Texas Metal Buildings and a metal building construction contractor may contact me at the phone number and email address I provided, including by automated phone calls and prerecorded messages, regarding metal building construction services. Consent is not a condition of any purchase. Message and data rates may apply. I may opt out at any time by asking to be removed during any call or by replying to any email. See our Privacy Policy.

Each request is routed to one independent contractor and is not sold to any lead list.

By phone instead: (737) 345-0282.

Last stop on the routing sheet: the price
